Field Observation, Comms Room Decommissioning

Clearing an old comms cabinet?
Get a written do-not-touch list before anyone pulls a cable.

In April 2020 a technician cleared a cabinet of retired gear and took Cloudflare's dashboard and API offline for 4 hours 21 minutes. The patch panel in that cabinet carried every external link from the site. This is the 2-hour audit that stops the same thing happening in your comms room.

25,669LinkedIn impressions
18,331People reached
4h 21mCloudflare outage
34 yearsOn live networks

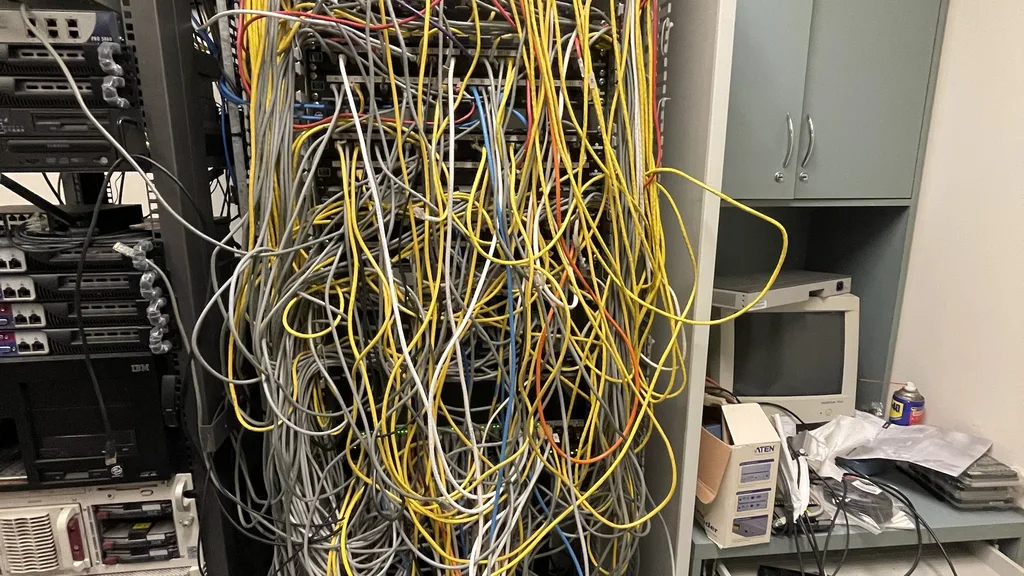

Comms room cabinet with a dense tangle of unlabelled patch leads and a few green switch lights showing which links are live.

Actual field photograph. A live comms room cabinet on an AAA site visit, Australia, 2026. The only sign of what is still live is a few green lights.

Short answer: before you decommission a comms cabinet, trace every link in it to its far end, tag each one live or retired, label what stays and put the do-not-touch list in writing. Only then does anything get unplugged.

AAA Communications is a Sydney-based network cabling and infrastructure company. We have worked on live office, branch, retail and industrial networks since 1992 and deliver nationally. Clearing old cabinets is routine work for us, and the audit always comes first.


Three minutes of tidy-up. Five hours to get it back.

On 15 April 2020, Cloudflare ran planned maintenance at one of its two core data centres. The job looked simple: retire a cabinet of old, inactive equipment. Technicians were told to remove everything in it.

That cabinet also held a patch panel. It carried every external link from that site to the rest of Cloudflare's network. Diverse providers. Diverse routes. One panel. Over the space of three minutes, those cables came out with everything else.

Outage
4 hours 21 minutes
Dashboard and API offline, 1531 to 1952 UTC.
Cause
3 minutes of unplugging
Every external link from the site ran through one patch panel in the cabinet being cleared.
Full recovery
About 5 hours
Fully redundant connectivity was restored at 2031 UTC.
The pressure
A decision every 20 minutes
Keep restoring the links, or fail over to disaster recovery.
What slowed it down

The repair was not the slow part. Working out which cables mattered was. Cloudflare's own post-mortem says the team lost valuable time identifying the critical cables for the technicians on site, because nothing was labelled for fast identification.

Cloudflare published the post-mortem themselves. Their fix list is short:

Cloudflare's fix list
  • Spread external links across the facility, not through one patch panel.
  • Label cables and panels so the critical ones can be found fast.
  • Spell out in writing what must not be touched before anyone starts.

No software fault. No attack. A patch panel and a set of unlabelled cables. Source: Cloudflare Dashboard and API Outage on April 15, 2020.

Six years on, more of your business runs through that panel.

The cause hasn't changed. What has changed is how much rides on it. Cloud apps, Wi-Fi 7 access points, cameras and door access all land on patch panels like these. The cabinets that get cleared out are usually the oldest ones on site, with the least documentation and the most changes since anyone last wrote anything down.

We see the same pattern behind walls and under floors. Each trade leaves something behind and nobody updates the record. Our piece on 14 cable types in one undocumented wall shows where that ends up, and a network documentation audit explains how far the drawings usually drift from what is installed.

Three checks before anyone touches a cabinet.

If a cabinet fails any of these, it doesn't get cleared until it has been traced.

01
Which ports carry a link off site?
Carrier services, links to other buildings and links to other floors often land on the same panel as retired gear. Cloudflare had diverse providers and diverse routes, and they all ended on one panel.
02
Any port with a live link light and no label?
A green light means something at the far end is still talking. No label means nobody can tell you what. That combination is the one that causes outages.
03
Anything powered from a circuit that also feeds something else?
Retiring a power rail or UPS in the cabinet can drop equipment that is meant to stay. Power gets traced the same way as data.

"In a cabinet like this, the only thing telling you what's live is a few green lights."

Pre-decommission site assessment, A$290 ex GST.

We don't touch a cabinet until it is traced. On every remediation, upgrade and comms room decommission, the audit comes first: what's live, what's retired, what's labelled, and what nobody touches. Then the plan. Then the work.

What it coversOne comms room cabinet and its links
What we doCheck every patch lead and port against what is actually connected, and note what is live and what must not be touched
Time on siteUp to 90 minutes
What you provideAccess to the comms room and any existing plans you have
What you getA report within 48 hours of the visit, with a photo for every fault and the test results for every link tested
PriceA$290 ex GST
CreditCredited in full if you go ahead with the quoted work
Scoped separatelyFailover testing with your team on hand, the removal, a cabinet reset, the go-live afterwards, and the tested outlet map described below
A$290, credited if you go ahead

The A$290 is credited in full if you go ahead with the quoted work. We are on site for up to 90 minutes and your report comes back within 48 hours of the visit.

We have run more than 1,000 of these trace-and-label jobs over 34 years. On every cabinet replacement, upgrade and remediation, it is the standard first step, and we have dressed and labelled 350 enclosures along the way. It's why unplanned outages on our jobs are rare. The ones we hear about happen where that step was skipped.

Once the report is in, the next step depends on the cabinet. If the gear is staying and the cabinet needs sorting, Cabinet Reset is the defined package for that. If you are replacing the cabinet and keeping some equipment, here is what to keep, what to relabel and what the handover should contain. If the concern is the whole site rather than one cabinet, start with a Layer 1 Network Audit. And if you are counting on a backup link that nobody has tested, read why your redundant network has never actually failed over.

If someone started clearing your oldest cabinet tomorrow, would anything stop them pulling a live link?

The trace is step one, not the whole job.

The audit tells you what is safe to pull. The next step tells you what every remaining outlet is for, and whether it can carry what you plan to put on it.

We trace each outlet to its port, document which application and which department uses it, and Fluke test the cable and port so you know it will carry the load you expect next, including the PoE power new access points, cameras and phones need. That work is scoped separately from the A$290 site assessment, because its size depends on how many outlets you have.

Why the outlet map matters

That map is what the next decisions are built on: VLANs that keep finance, cameras and guest Wi-Fi apart, an SD-WAN rollout that knows what each site actually runs, and the segmentation that cyber resilience depends on. Skip the trace and every one of those steps is designed on guesswork. More on that in physical network constraints on cyber resilience.

Engineers recognised this cabinet straight away.

When this story went up on LinkedIn it reached 18,331 people across the UK, US and Australia, mostly network, systems and infrastructure engineers, IT managers and architects. It drew 60 comments. These are the points the thread made, not the quotes.

Senior Enterprise Network Engineer
First reaction to the photo was that it had to be fake. It isn't. Live comms rooms look like this more often than anyone admits.
Network System Engineer
Label the cable as soon as it is terminated and the link tests good. It was one of the first habits learned as an apprentice, and the gap shows up at most telcos when it gets skipped.
FTTP Planner & Surveyor
For experienced field people, untangling a cabinet like this is a challenge they miss, not one they avoid.
Data Centre Operations Lead
Has recabled an aggregation like this during maintenance windows. Trace, track and label both ends in one window, then clean up in later windows. Nothing rushed.
Principal Network Architecture & Security Consultant
The oldest server in the room is usually the one nobody dares switch off. If it is still running, a business process somewhere depends on it, and nobody has written down which one.
Electrical Trades Member
A cabinet like this does not happen overnight. It builds up over years of small shortcuts.

Comms cabinet decommissioning, explained.

What should you check before decommissioning a comms cabinet?
Trace every link to its far end, tag each one live or retired, label what stays and write down what must not be touched. Check three things first: which ports carry a link off site, any port with a live link light and no label, and anything powered from a circuit that also feeds other equipment.
How long does a pre-decommission site assessment take?
Up to 90 minutes on site for one comms room cabinet. The report follows within 48 hours of the visit.
What do we need to provide?
Access to the comms room and any existing plans or records you have. We check the physical links ourselves, so switch logins are not needed.
How much does a pre-decommission site assessment cost?
A$290 ex GST for one comms room cabinet: up to 90 minutes on site, report within 48 hours, credited in full if you go ahead with the quoted work.
What happens after the audit?
You decide. The report tells you what we found and what we recommend for the next stage. If you want us to do the removal, a Cabinet Reset, failover testing or the go-live afterwards, we scope and quote that work separately, and the A$290 is credited in full if you go ahead with the quoted work.

Clearing a cabinet soon? Trace it first.

One comms room cabinet. Up to 90 minutes on site, report within 48 hours. A$290 ex GST, credited in full if you go ahead with the quoted work.
