Aruba 2530 replacement

Will your replacement switch fit the cabinet it's replacing?

Not guaranteed, even from the same vendor. EIA-310 fixes three dimensions: the 19-inch mounting width, the rack unit height and the hole spacing. Depth, airflow direction and mounting post position are left to the manufacturer. A compliant switch can still fail to fit a compliant cabinet, so measure before you order.

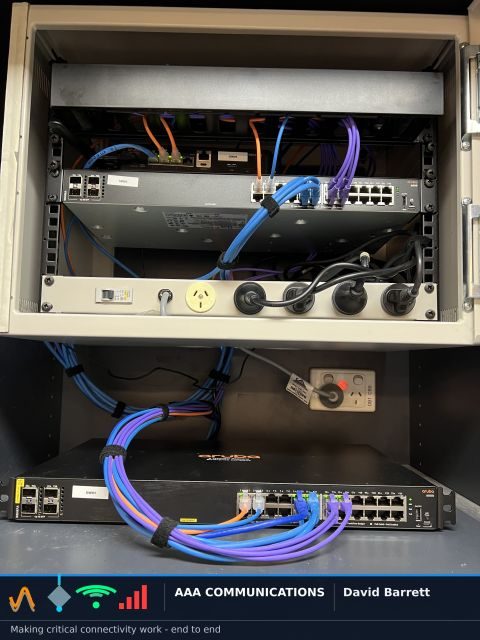

Aruba switch sitting outside a wall-mounted comms cabinet during a refresh, patched back into the rack with exposed leads

What does EIA-310 actually standardise?

Three things: the 19-inch mounting width, the rack unit height of 1.75 inches (44.45 mm), and the hole spacing. That's it.

Depth, clearance, airflow direction and mounting post position are all left to the manufacturer. Two compliant cabinets can look nothing alike. Two compliant switches from the same vendor lineage can end up incompatible with the same rack, five years apart.

On a lot of the sites we get called into, the cabinets were specified a decade ago for a different generation of hardware, and the mounting posts are adjustable. Adjustable means the usable depth was never actually fixed. It only gets confirmed when someone puts a tape measure on it.

Why does this matter for an Aruba 2530 replacement?

Because "recommended replacement" in a vendor end-of-sale notice means feature and port equivalence, not physical equivalence.

HPE names the CX 6000 as the recommended replacement for the 2530. It runs AOS-CX, a different operating system from the ProVision-based AOS-S the 2530 runs. None of that tells you anything about depth, airflow direction or where the mounting ears sit on the new chassis.

HPE ended sales of the 2530 Gigabit models on 31 October 2021. Support end dates are listed per part number in HPE's warranty reference, so check yours by SKU, not by family. Entry-level access switches like the 2530 tend to live in the smallest cabinets on the network: wall-mounted comms cabinets in branches, clinics and retail sites, where usable depth is tightest.

What does a fitment failure look like on site?

It looks like a new switch sitting outside the cabinet it was bought for.

Refresh projects get treated as a procurement event. Order the switch, decommission the old one, slot in the new. Nobody measures the cabinet first. On one of our jobs, the new switch sat on a trolley for four days because nobody checked post depth until decommission day. The PO was already closed out.

It isn't a one-off.

Max Migliore, Founder and Principal Consultant, All Digital
"I have seen this many times, with the new switch ending up sitting on the rack or on a desk because it didn't fit inside."

Switches sitting outside their enclosure during cutover aren't a cosmetic problem. It's an open chassis, exposed patching, no thermal or dust protection, and cable strain nobody accounted for.

Who pays when the new switch doesn't fit?

Usually the integrator, because the failure surfaces after the PO is closed and lands on whoever is holding the job on the day.

Then three parties point at each other. The integrator says the scope wasn't theirs. The client says they trusted the quote. The vendor says the spec sheets were published. If you're signing off a refresh, check the quote for scope gaps before you sign.

Eric Scher, a Senior Project Manager in telecom, construction and infrastructure program delivery based in New York, first gave the answer most people give:

"Whomever failed to do the front end planning."

Asked who that actually is, he didn't deflect:

Eric Scher, Senior Project Manager, Program Delivery, Telecom, Construction and Infrastructure
"That would be me. Ultimately, that would be a failure of leadership on my part."

That's the difference between a PM who fixes the scoping process and one who adds a checklist nobody follows. Fitment is a scoping decision. It gets made before the order goes in, or it gets paid for twice. For the wider question of who owns the risk in that cabinet, start here.

What does doing it properly look like?

It looks like a rack compatibility check written into the plan as its own step.

Eric ran an upgrade at Columbus Public Schools about 20 years ago: Cisco 8510s out, 4503s in.

"You can be certain that we specifically checked for rack compatibility."

Nobody's job description includes "go measure the old cabinet". That's exactly why it has to sit inside someone's scope.

Eric Scher
"If I assign a task to a person or group, which starts with 'A' and ends with 'Z', I would expect them to understand that they are ALSO responsible for 'B' through 'Y'."

What should you check before the order goes in?

Six measurements, taken on site, against the new model's datasheet. This is the core of a cabinet and rack fitment audit before the refresh order goes in.

  1. Usable depth. Front mounting rail to the nearest rear obstruction, with the door closed.
  2. Rail position. Where the posts sit now, and whether they're adjustable.
  3. Airflow direction. The new unit's airflow against the cabinet's cooling path. Mismatched airflow is how you end up with a rack running hotter than anyone notices.
  4. Front clearance. Room for patch lead bend radius once the door closes.
  5. Rear clearance. Power cords and inlets, plus anything mounted behind the switch.
  6. Mounting support. Whether the new chassis needs rear support brackets for its weight.

A hardware refresh that doesn't survive contact with the cabinet isn't finished. It's a project that will get billed twice.

AAA Communications, a Sydney-based Layer 1 infrastructure specialist and Telstra Partner since 1992, checks cabinet depth, rail position and airflow before refresh hardware is ordered, on live sites nationally.

Aruba 2530 replacement, explained.

Does EIA-310 specify rack depth?
No. EIA-310 standardises the 19-inch mounting width, the rack unit height of 44.45 mm and the hole spacing. Depth, airflow direction and mounting post position are left to the cabinet and equipment manufacturers.
Will an Aruba CX switch fit where a 2530 was?
Not automatically. The CX 6000 is HPE's recommended replacement for the 2530, but that's a functional replacement, not a physical one. Check the new model's datasheet depth and airflow direction against the measured usable depth of the existing cabinet before ordering.
How do I measure usable cabinet depth?
Measure from the front mounting rail to the nearest rear obstruction with the door closed, whether that's the rear panel, cable management, a power rail or the wall. Then allow front clearance for patch lead bend radius and rear clearance for power cords.
Who is responsible if a replacement switch doesn't fit?
It's usually contested between the integrator, the client and the vendor. The root cause sits upstream in scoping. Whoever owns the refresh scope owns the cabinet check.
When should the cabinet check happen in a refresh?
Before the purchase order is raised. After decommission day, the old switch is gone, the PO is closed, and every fix costs extra time and a second invoice.

Measure before you order.

Send us 3 photos of the cabinet. A technician tells you whether the new switch will fit before you place the order. Free, same day.
